Weed 68: (Oct 3- Oct 10, 2024) Building the Jolley School in Timo

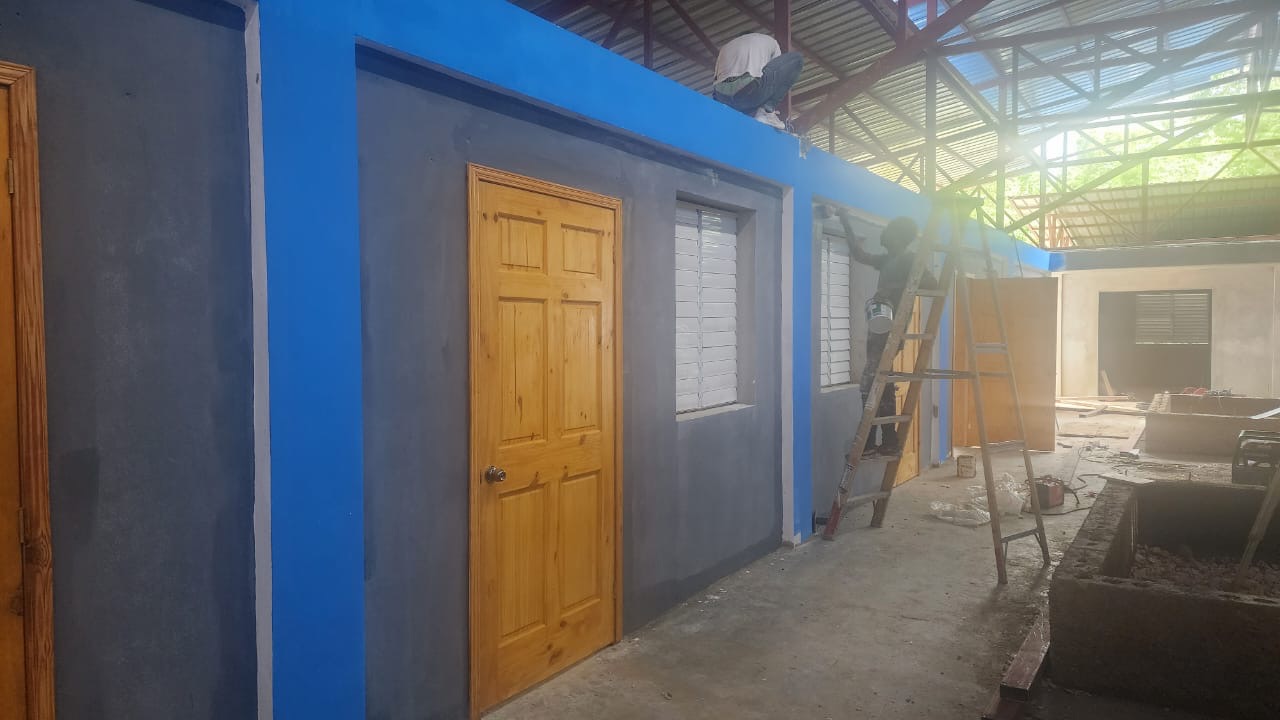

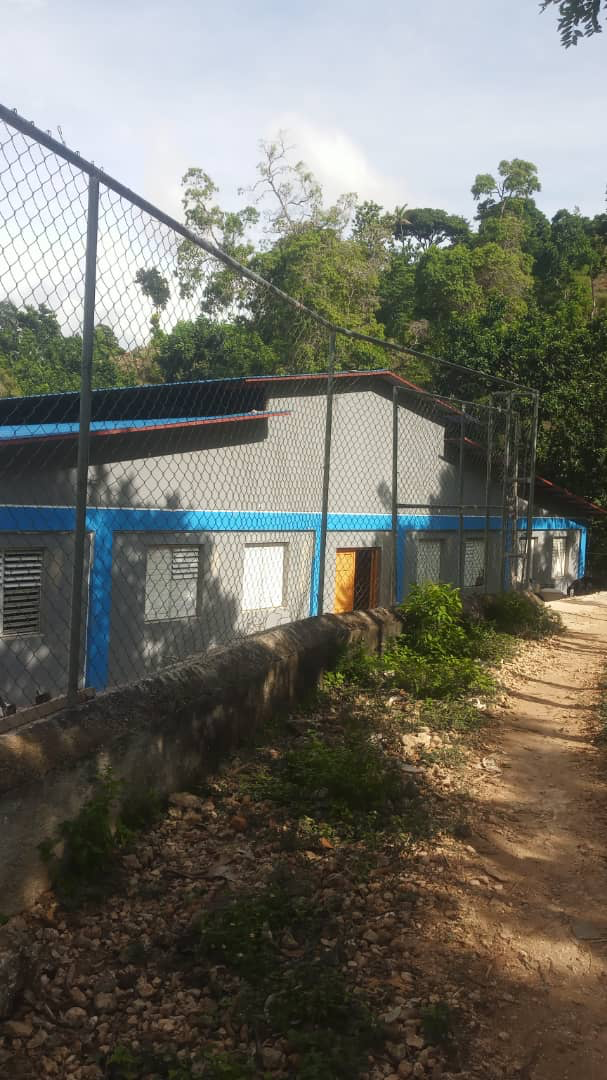

Recap: Steel reinforcement for concrete floor between Block 5 (Kitchen/Cafeteria), 100%. Electrical work Block 5 hallway 3 & 4, 50%. Pouring concrete parquet flooring, Block 5 (Kitchen/Cafeteria), 60%. Application of paint on walls, 50% Classroom doors installation, 100% Manufacturing student benches/desks, 45% Windows installation Our operations are currently at the following stages: Wall finishing; Building… Continue reading Weed 68: (Oct 3- Oct 10, 2024) Building the Jolley School in Timo

Week 67 – (Sept 26- Oct 3, 2024) Building the Jolley School in Timo

Update!!! Steel reinforcement hallway between Block (Classrooms 1-3) and Block 4(Classrooms 4-6), 100%. Electrical installation hallway between Block 3(Classrooms 1-3) and block 4(Classrooms 4-6), 100%. Pouring concrete parquet flooring main hallway, 100%. Electrical work classroom ceilings, 100%. Pouring concrete parquet flooring, Block 5 (Kitchen/Cafeteria), 80%. Making school bench, 45%. Laying concrete blocks for planter boxes… Continue reading Week 67 – (Sept 26- Oct 3, 2024) Building the Jolley School in Timo

Week 66 – Sept 18-25, 2024 – Building the Jolley School, Timo Haiti

Below is a summary of activities completed during the previous period. Pouring concrete parquet flooring main corridor: This activity is completed at 85% during this week.  Pouring concrete parquet flooring, block 5 (cafeteria) :  This activity is not completed during this week.       Electrical installation of classroom ceilings: This activity is not completed during this week.… Continue reading Week 66 – Sept 18-25, 2024 – Building the Jolley School, Timo Haiti

Week 65 (Sept 11-Sept 18, 2024) – Building the Jolley School, Timo Haiti

Update!!! (100%)|Pouring concrete parquet flooring, block 4 (Classrooms 4-6), 100%. Steel reinforcement plant boat, 100%. Formwork plant boat, 100%.  Pouring concrete plant boat, 100%.  Laying bloc plant boat, 50%. Steel reinforcement corridor between block 3 (Classrooms 1-3) and block 4(Classrooms 4-6), 50%.  Floating, block 5(Cafeteria), 100%.  Main facade preparation,100%. Bench preparation, 20%.  Saddling socket,90%

Week 64 (Sept 4-Sept 11, 2024) – Building the Jolley School, Timo Haiti

Update on progress: pouring concrete parquet flooring,block 4 ( Classrooms 4-6); This activity is completed at 75% during this week. Paint work block 4(Classrooms 4-6) : This activity is completed at 30 % during this week. plant boat excavation : This activity is completed during this week, 100%. Backfilling corridor between block 3(Classrooms 1-3) and… Continue reading Week 64 (Sept 4-Sept 11, 2024) – Building the Jolley School, Timo Haiti
