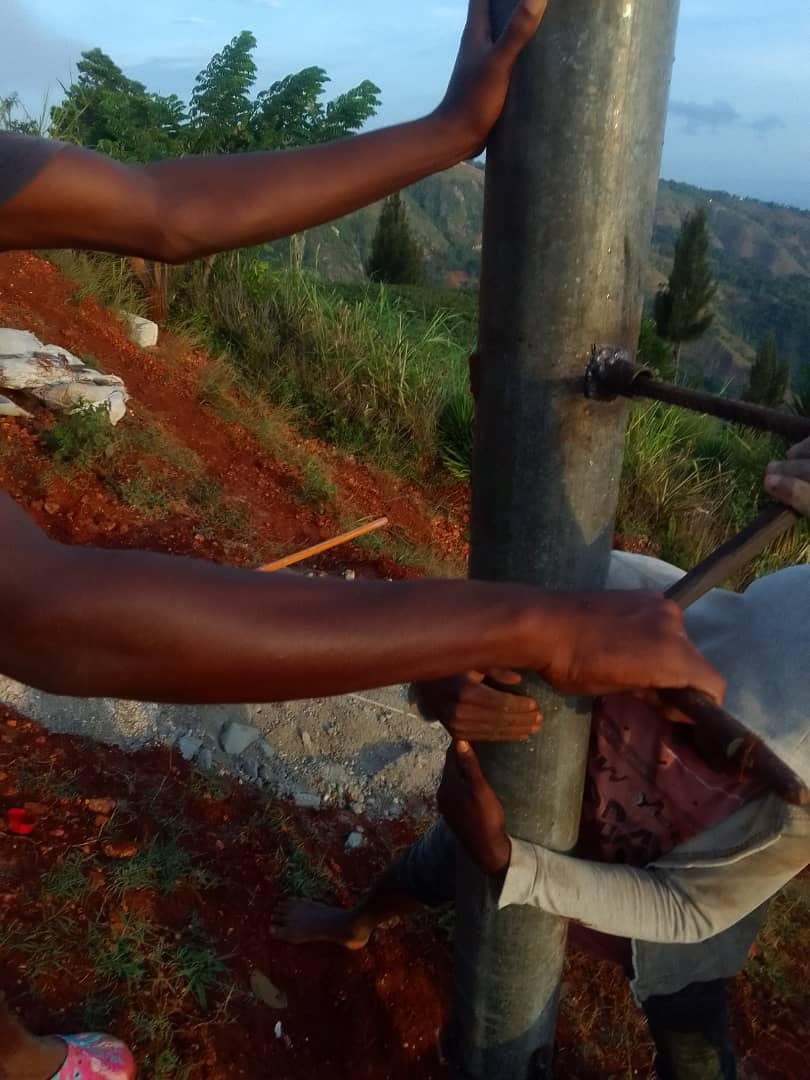

Week 61 (Aug 14-Aug 21, 2024) – Building of the Jolley School

Review of activities from the previous period : Transportation of doors, 19 units 100%. Transportation of windows, 100%. 21 units Steel reinforcement parquet floor, block 3 (Classrooms 1-3) ,100%. Electrical flooring, block 3(Classrooms 1-3), 100%. Concrete pouring parquet floor, block 3(Classrooms 1-3), 70%. Plug sealing, block 1(Administration) ,100%.  Plug sealing, block 2(Library / Computer) ,100%.… Continue reading Week 61 (Aug 14-Aug 21, 2024) – Building of the Jolley School

Week 60 (Aug 7-Aug 14) – Building of the Jolley School

Recap: concrete pouring parquet floor, block 1(Administration), 100%. concrete pouring parquet floor, block 2(Library / Computer), 100%. Aluzinc sheet metal installation, block 5,100 %. Floating, block 3 (Classrooms 1-3), 100 %.  Floating, block 4 (Classrooms 4-6), 100%. Aluzinc sheet metal installation, main corridor, blocks 3(Classrooms 1-3) and 4(Classrooms 4-6), 100%. Transportation of windows for blocks… Continue reading Week 60 (Aug 7-Aug 14) – Building of the Jolley School

Week 59 (July 31-Aug 7, 2024) Building of the Jolley School

Review of activities: Steel framing, block 1 (Administration), 100%. Steel framing, block 2 (Library / Computer), 100%. Electrical installation, block 1 (Administration) ,100%. Electrical installation, block 2 (Library / Computer) ,100%. Floating, block 1 (Administration), 95%. Floating, block 2 (Library / Computer), 95%. Floating, block 3 (Classrooms 1-3), 100%. Steel structure for roofing, block 5(Cafeteria),… Continue reading Week 59 (July 31-Aug 7, 2024) Building of the Jolley School

Week 58 (July 24-July 31, 2024) – Building of the Jolley School

Update: Aluzinc sheet metal installation main ridge, 70%. Aluzinc sheet metal installation, block 1(Administration), 100%. Aluzinc sheet metal installation, block 2(Library / Computer), 70%. Aluzinc sheet metal installation, block 3(Classrooms 1-3), 100%. Aluzinc sheet metal installation, block 4(Classrooms 4-6), 70%. Floating, block 1 (Administration), 90%. Floating, block 2 (Library / Computer), 80%. Plastering chain beam,… Continue reading Week 58 (July 24-July 31, 2024) – Building of the Jolley School

WEEK 51 (June 5-12, 2024) – Building the Jolley School, Timo Haiti

WEEK 52 (June 12-19) Below is a summary of activities completed during the previous period. a) Aluzinc sheet metalinstallation, block 1(Administration): This activity is completed at 5 % during this week. b) laying laths (metalroofing), block 1 (Administration): This activity is completed at 100 % during this week. c) laying laths (metalroofing) , block 2… Continue reading WEEK 51 (June 5-12, 2024) – Building the Jolley School, Timo Haiti

Week 47 (May 8-15, 2024) Building the Jolley School, Timo Haiti

Week 47 (May 8-15, 2024) HIGHLIGHT: we are at the end of STEP 4 (Step 4 Vertical Wall Erection: Concrete Block and Masonry) of the Calendar of Activities agreed upon on May 18, 2024 UPDATES: -Steel reinforcement for top chain beam, Block 1 (Administration), 60% complete -Steel reinforcement for top chain beam, Block 2 (Library… Continue reading Week 47 (May 8-15, 2024) Building the Jolley School, Timo Haiti

Week 46 Update (May 1-8, 2024) Building the Jolley School, Timo Haiti

Week 46 Update – May 1-8, 2024 Below is a summary of activities completed during the previous period. 1. Formwork steel columns, Block 1 (Administration) & Block 2 (Library/ Computer), 100% complete 2. Concrete pouring over steel columns, Block 1 (Administration) & Block 2 (Library/ computer), 100% complete 3. Concrete pouring over steel columns, Block… Continue reading Week 46 Update (May 1-8, 2024) Building the Jolley School, Timo Haiti

Week 44 (April 17-24, 2024) Building the Jolley School, Timo Haiti

Week 44 (April 17-24, 2024) Below is a summary of activities completed during the previous period. -Laying cement blocks for partition walls, Block 5 (Kitchen/Cafeteria), 100% complete -Formwork for doors and windows, Block 5 (Kitchen/Cafeteria), 100% complete -Concrete pouring for doors and windows, Block 5 (Kitchen/Cafeteria), 100% complete. -Concrete pouring for front door threshold, Block… Continue reading Week 44 (April 17-24, 2024) Building the Jolley School, Timo Haiti
