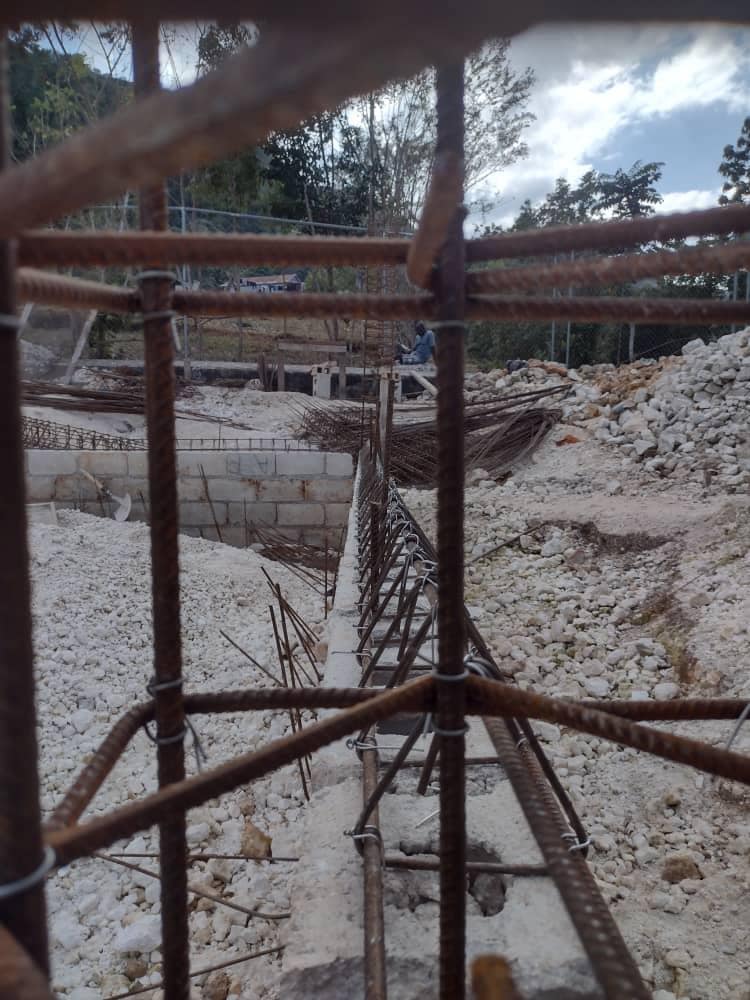

Week 62 (Aug 21-Aug 28) – Building of the Jolley School

Update: Steel reinforcement parquet floor, block 4 (Classrooms 4-6),100%. Electrical flooring, block 4(Classrooms 4-6), 100%. concrete pouring parquet floor, block 3(Classrooms 1-3), 100%. Floating, block 3(Classrooms 1-3), 100%. Concrete pouring parquet floor, block 3(Classrooms 1-3), 100%. Plug sealing, block 4(Classrooms 4-6) ,100%. Purchase and transport of 300 bags of cement (100%). Facade préparation (100%).

Week 61 (Aug 14-Aug 21, 2024) – Building of the Jolley School

Review of activities from the previous period : Transportation of doors, 19 units 100%. Transportation of windows, 100%. 21 units Steel reinforcement parquet floor, block 3 (Classrooms 1-3) ,100%. Electrical flooring, block 3(Classrooms 1-3), 100%. Concrete pouring parquet floor, block 3(Classrooms 1-3), 70%. Plug sealing, block 1(Administration) ,100%.  Plug sealing, block 2(Library / Computer) ,100%.… Continue reading Week 61 (Aug 14-Aug 21, 2024) – Building of the Jolley School

Week 60 (Aug 7-Aug 14) – Building of the Jolley School

Recap: concrete pouring parquet floor, block 1(Administration), 100%. concrete pouring parquet floor, block 2(Library / Computer), 100%. Aluzinc sheet metal installation, block 5,100 %. Floating, block 3 (Classrooms 1-3), 100 %.  Floating, block 4 (Classrooms 4-6), 100%. Aluzinc sheet metal installation, main corridor, blocks 3(Classrooms 1-3) and 4(Classrooms 4-6), 100%. Transportation of windows for blocks… Continue reading Week 60 (Aug 7-Aug 14) – Building of the Jolley School

Week 59 (July 31-Aug 7, 2024) Building of the Jolley School

Review of activities: Steel framing, block 1 (Administration), 100%. Steel framing, block 2 (Library / Computer), 100%. Electrical installation, block 1 (Administration) ,100%. Electrical installation, block 2 (Library / Computer) ,100%. Floating, block 1 (Administration), 95%. Floating, block 2 (Library / Computer), 95%. Floating, block 3 (Classrooms 1-3), 100%. Steel structure for roofing, block 5(Cafeteria),… Continue reading Week 59 (July 31-Aug 7, 2024) Building of the Jolley School

Week 58 (July 24-July 31, 2024) – Building of the Jolley School

Update: Aluzinc sheet metal installation main ridge, 70%. Aluzinc sheet metal installation, block 1(Administration), 100%. Aluzinc sheet metal installation, block 2(Library / Computer), 70%. Aluzinc sheet metal installation, block 3(Classrooms 1-3), 100%. Aluzinc sheet metal installation, block 4(Classrooms 4-6), 70%. Floating, block 1 (Administration), 90%. Floating, block 2 (Library / Computer), 80%. Plastering chain beam,… Continue reading Week 58 (July 24-July 31, 2024) – Building of the Jolley School

WEEK 52 (June 12-19, 2024) – Building the Jolley School, Timo Haiti

WEEK 52 (June 12-19, 2024) Below is a summary of activities completed during the previous period. a) Aluzinc sheet metalinstallation, block 1(Administration): This activity is completed at 5 % during this week. b) laying laths (metalroofing), block 1 (Administration): This activity is completed at 100 % during this week. c) laying laths (metalroofing) , block… Continue reading WEEK 52 (June 12-19, 2024) – Building the Jolley School, Timo Haiti

WEEK 51 (June 5-12, 2024) – Building the Jolley School, Timo Haiti

WEEK 52 (June 12-19) Below is a summary of activities completed during the previous period. a) Aluzinc sheet metalinstallation, block 1(Administration): This activity is completed at 5 % during this week. b) laying laths (metalroofing), block 1 (Administration): This activity is completed at 100 % during this week. c) laying laths (metalroofing) , block 2… Continue reading WEEK 51 (June 5-12, 2024) – Building the Jolley School, Timo Haiti

WEEK 50 (May 29-June 5, 2024) – Building the Jolley School, Timo Haiti

WEEK 50 (May 29-June 5, 2024) The skilled workers are not native to Timo but are provided with temporary accommodation in the Timo community during the construction project. The skilled workers include carpenters who build formwork; ironworkers who install steel reinforcement; and masons who pour concrete. The day laborers, natives of Timo, assist the skilled… Continue reading WEEK 50 (May 29-June 5, 2024) – Building the Jolley School, Timo Haiti
