Week 47 (May 8-15, 2024) Building the Jolley School, Timo Haiti

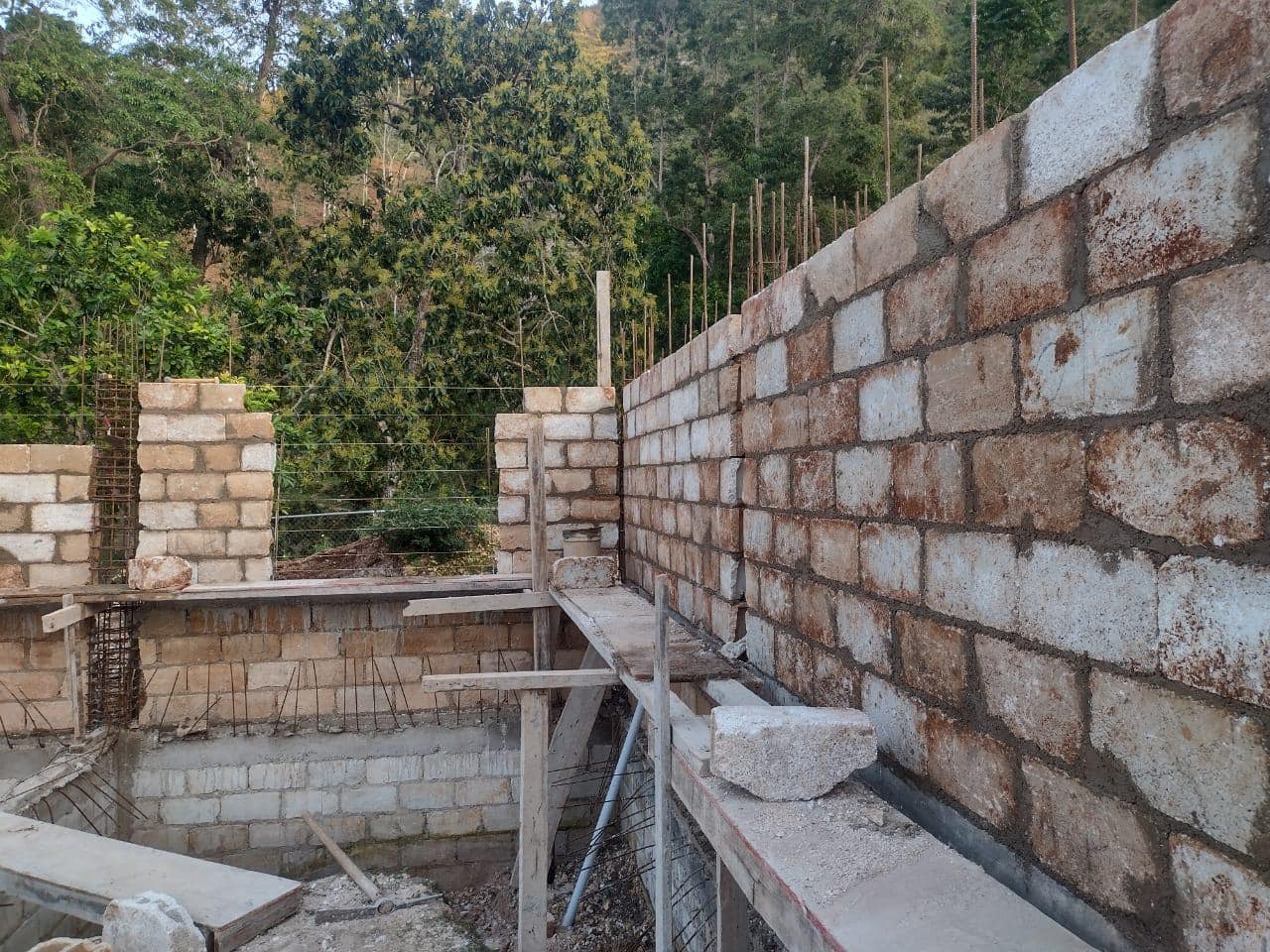

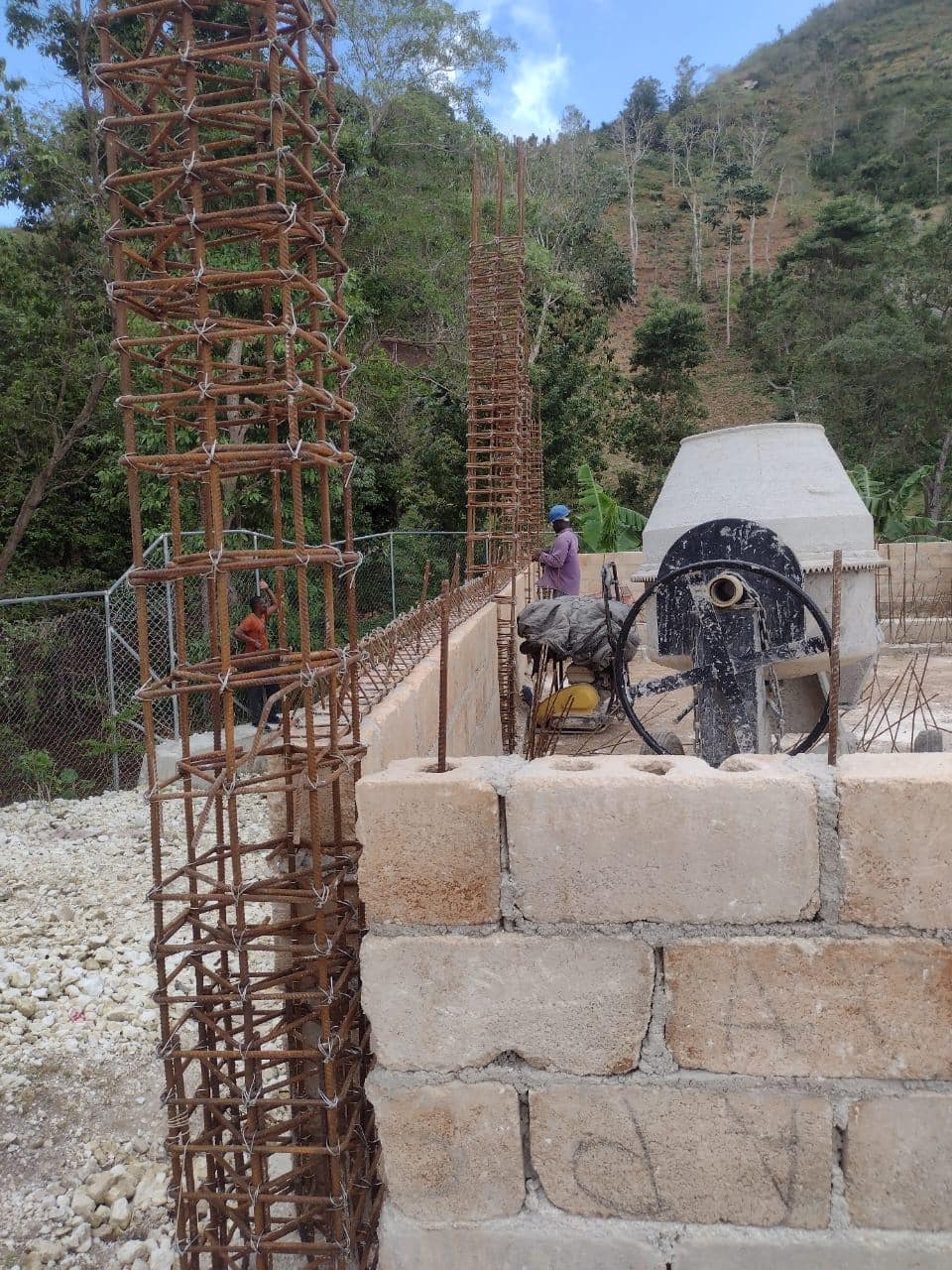

Week 47 (May 8-15, 2024) HIGHLIGHT: we are at the end of STEP 4 (Step 4 Vertical Wall Erection: Concrete Block and Masonry) of the Calendar of Activities agreed upon on May 18, 2024 UPDATES: -Steel reinforcement for top chain beam, Block 1 (Administration), 60% complete -Steel reinforcement for top chain beam, Block 2 (Library… Continue reading Week 47 (May 8-15, 2024) Building the Jolley School, Timo Haiti

Week 46 Update (May 1-8, 2024) Building the Jolley School, Timo Haiti

Week 46 Update – May 1-8, 2024 Below is a summary of activities completed during the previous period. 1. Formwork steel columns, Block 1 (Administration) & Block 2 (Library/ Computer), 100% complete 2. Concrete pouring over steel columns, Block 1 (Administration) & Block 2 (Library/ computer), 100% complete 3. Concrete pouring over steel columns, Block… Continue reading Week 46 Update (May 1-8, 2024) Building the Jolley School, Timo Haiti

Week 44 (April 17-24, 2024) Building the Jolley School, Timo Haiti

Week 44 (April 17-24, 2024) Below is a summary of activities completed during the previous period. -Laying cement blocks for partition walls, Block 5 (Kitchen/Cafeteria), 100% complete -Formwork for doors and windows, Block 5 (Kitchen/Cafeteria), 100% complete -Concrete pouring for doors and windows, Block 5 (Kitchen/Cafeteria), 100% complete. -Concrete pouring for front door threshold, Block… Continue reading Week 44 (April 17-24, 2024) Building the Jolley School, Timo Haiti

Week 43 (April 10-17, 2024) — Building the Jolley School, Timo Haiti

Week 43 (April 10-17, 2024) Progress made: -Transported steel rebar for roofing to the site 111 rebar 2×4, and 123 rebar 2×2, 20% complete -Preparation of the top chain beam, Block 1 (Administration), 0% complete -lmplantation of a green space in the main corridor between Block 3 (Classrooms 1-3) and Block 4 (Classrooms 4-6), 0%… Continue reading Week 43 (April 10-17, 2024) — Building the Jolley School, Timo Haiti

Week 42 (April 3-10, 2024) — Building the Jolley School, Timo Haiti

Week 42 (April 3-10, 2024) Recap: -We are still at STEP 4 (Step 4 Vertical Wall Erection: Concrete Block and Masonry) of the Calendar of Activities agreed upon on May 18, 2023. Below is a summary of activities completed during the previous period. -Steel reinforcement of door and window lintels, Block 1 (Administration) & Block… Continue reading Week 42 (April 3-10, 2024) — Building the Jolley School, Timo Haiti

Week 41 (March 28-April 4, 2024) — Building the Jolley School, Timo Haiti

Week 41 (March 28-April 4, 2024) Progress: -We are still at STEP 4 (Step 4 Vertical Wall Erection: Concrete Block and Masonry) of the Calendar of Activities agreed upon on May 18, 2023. -Below is a summary of activities completed during the previous period. -Steel columns installation, Block 5 (Kitchen/Cafeteria), 100% complete. -Laying cement blocks… Continue reading Week 41 (March 28-April 4, 2024) — Building the Jolley School, Timo Haiti

Week 40 (March 22-27, 2024) — Building the Jolley School, Timo Haiti

Week 40 (March 22-27, 2024) Recap: We are at STEP 4 (Step 4 Vertical Wall Erection: Concrete Block and Masonry) of the Calendar of Activities agreed upon on May 18, 2023. Below is a summary of activities completed during the previous period. 1. Laying cement blocks, Block 4 (Classrooms 4-6), 100% complete 2. Steel columns… Continue reading Week 40 (March 22-27, 2024) — Building the Jolley School, Timo Haiti

Weekly Report 38: (March 7-14, 2024)

Weekly Report 38: (March 7-14, 2024) Reflections: The construction of the Timo Community School is a tale of sacrifice and courage by numerous individuals. Local daily laborers from Timo have demonstrated remarkable strength while transporting heavy cement bags and blocks through rugged and muddy trails. Truck loaders in warehouses have loaded trucks during nighttime, and… Continue reading Weekly Report 38: (March 7-14, 2024)
