Week 36 (Feb 22-29, 2024)
Review of work for the week:

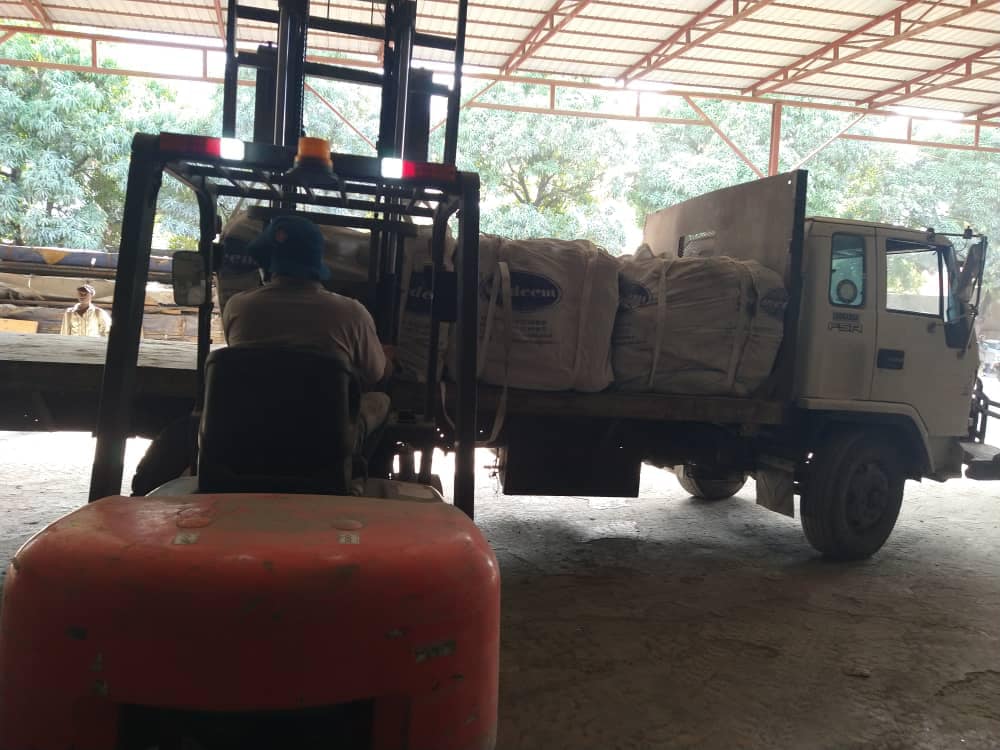

-Transported 4200 lbs of rebar from Leogane to Tavet, 100% of goal complete.
-Transported 200 cement bags from Petit Goâve to Tavet, 80% complete.
-Steel reinforcement for intermediary chain beam, Block 4 (Classrooms), 0% complete.

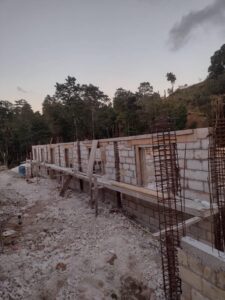

-Formwork for intermediate chain beam, Block 4 (Classrooms), 0% complete.
-Concrete pouring for intermediary chain beam, Block 4 (Classrooms), 0% complete.
-The planned activities at buildings 4 and 5, i.e., tasks 3, 4, 5, were not carried out for this week, following a decision by the technical team to concentrate their resources to finalize the structural work for Block 3 (Classroom).

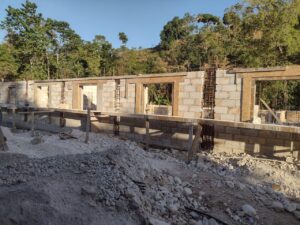

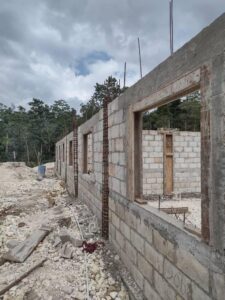

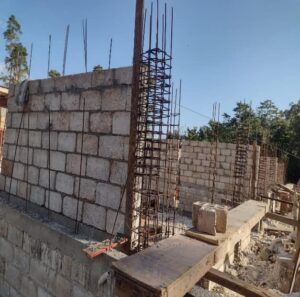

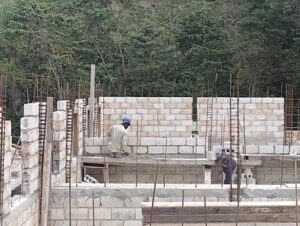

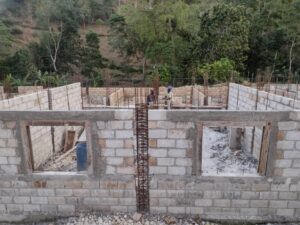

-Laying 15cm Block wall panel, Block 3 (Classrooms), 80% complete.
-Steel reinforcement for window frame, Block 3 (Classrooms), 100% complete.

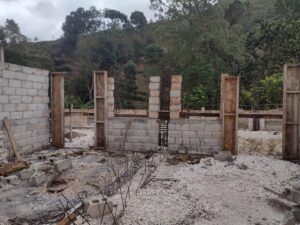

- Formwork including steel reinforcement for window frame, Block 3 (Classrooms), 100% complete.
-Concrete pouring for window frames, Block 3 (Classrooms), 100% complete.

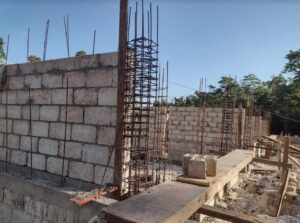

-Steel reinforcement for doors frame, Block 3 (Classrooms), 33% complete.
- Formwork reinforcement for doors frame, Block 3 (Classrooms), 33% complete.
