Progress made:

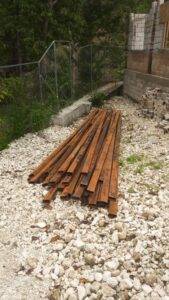

-Transported steel rebar for roofing to the site 111 rebar 2x4, and 123 rebar 2x2, 20% complete

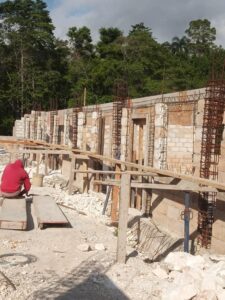

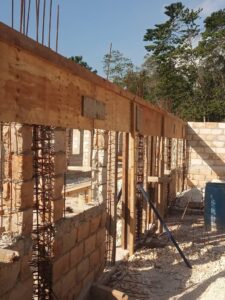

-Preparation of the top chain beam, Block 1 (Administration), 0% complete
-lmplantation of a green space in the main corridor between Block 3 (Classrooms 1-3) and Block 4 (Classrooms 4-6), 0% complete

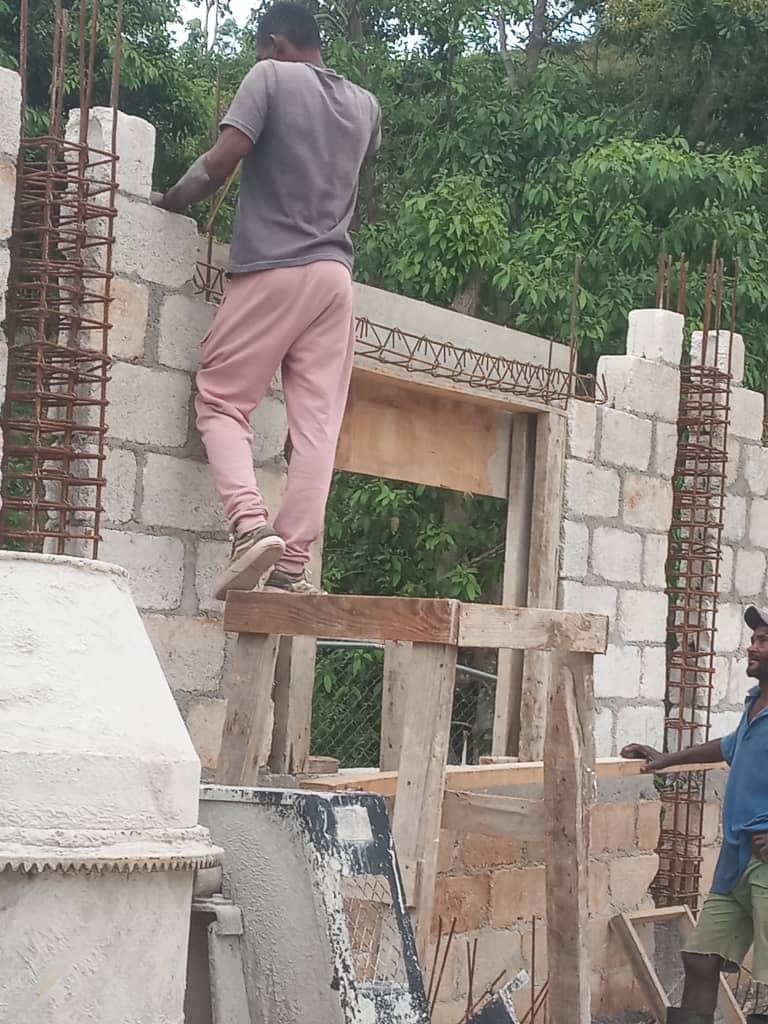

-Steel reinforcement of doors & windows, Block 4 (Classrooms 4-6), 100% complete.

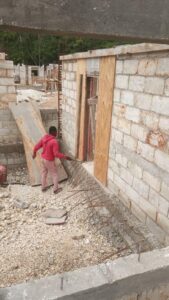

- We put the steel in place to prepare the concrete for the door and window lintels in Block 4.
-Formwork for doors and windows in Block 4, 100% complete
-Concrete pouring for doors and windows, Block 4, 100% complete

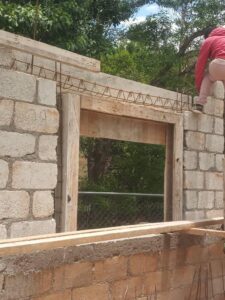

-Steel reinforcement windows (Installation of the steel for the preparation of concrete for window lintels), Block 5 (Kitchen/Cafeteria), 100% complete

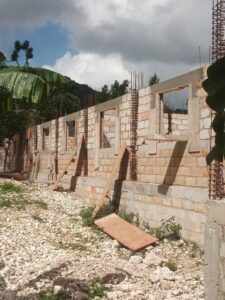

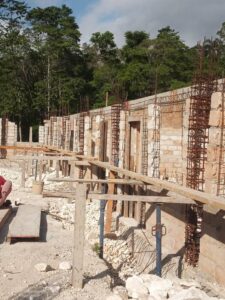

-Formwork for windows, Block 5, 80% complete

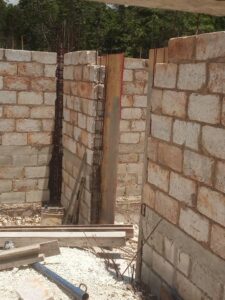

- Steel reinforcement doors, Block 1 (Administration) & Block 2 (Library/Computer Room), 100% complete
-Formwork doors, Blocks 1 &2, 70% complete
