Week 58 (July 24-July 31, 2024) – Building of the Jolley School
July 31, 20241 min read

Update:

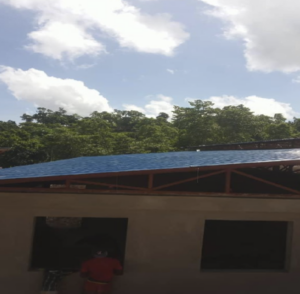

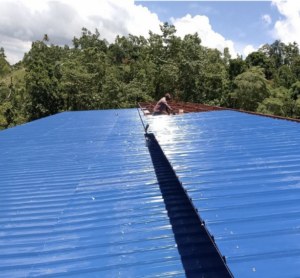

- Aluzinc sheet metal installation main ridge, 70%.
- Aluzinc sheet metal installation, block 1(Administration), 100%.
- Aluzinc sheet metal installation, block 2(Library / Computer), 70%.
- Aluzinc sheet metal installation, block 3(Classrooms 1-3), 100%.
- Aluzinc sheet metal installation, block 4(Classrooms 4-6), 70%.

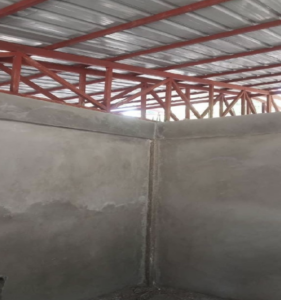

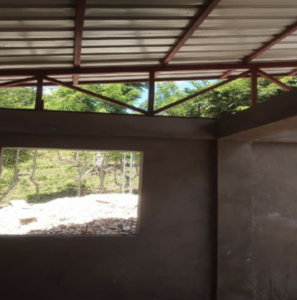

- Floating, block 1 (Administration), 90%.
- Floating, block 2 (Library / Computer), 80%.

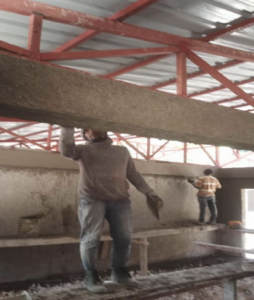

- Plastering chain beam, block 3 (Classrooms 1-3) ,50%.
- Floating, block 3 (Classrooms 1-3), 50%.

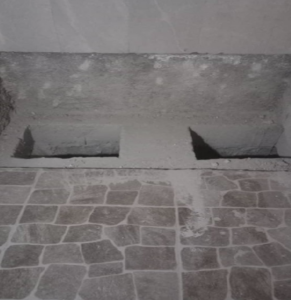

- Steel frame for parquet flooring, block 1 (Administration), 0%.
- Installation of electrical piping 1,0%.
- Steel frame for parquet flooring, block 2 (Library / Computer), 0%.
- Installation of electrical piping 1 ,0%.
- Demolition of latrine toilets,100%.

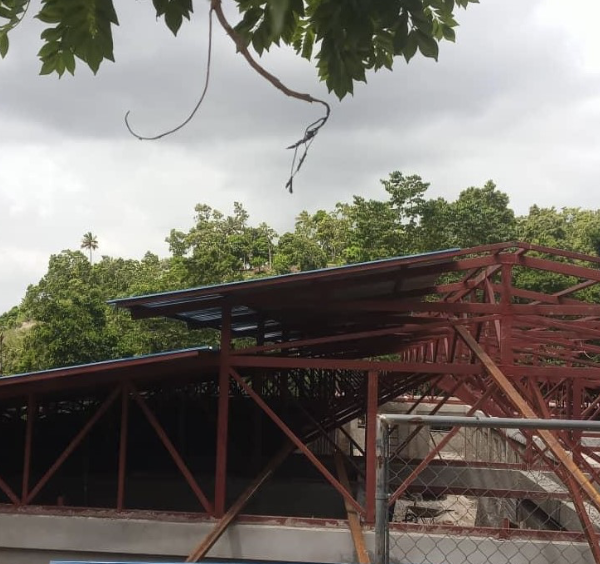

- Steel structure for roofing, block 5(Cafeteria), 50%.
