Week 59 (July 31-Aug 7, 2024) Building of the Jolley School
August 7, 20241 min read

Review of activities:

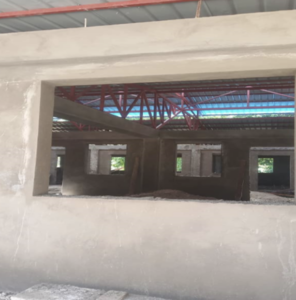

- Steel framing, block 1 (Administration), 100%.
- Steel framing, block 2 (Library / Computer), 100%.

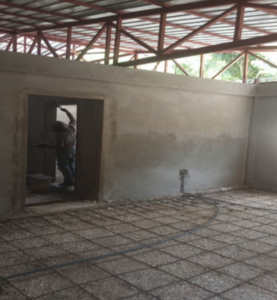

- Electrical installation, block 1 (Administration) ,100%.
- Electrical installation, block 2 (Library / Computer) ,100%.

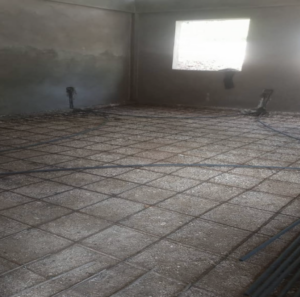

- Floating, block 1 (Administration), 95%.
- Floating, block 2 (Library / Computer), 95%.
- Floating, block 3 (Classrooms 1-3), 100%.

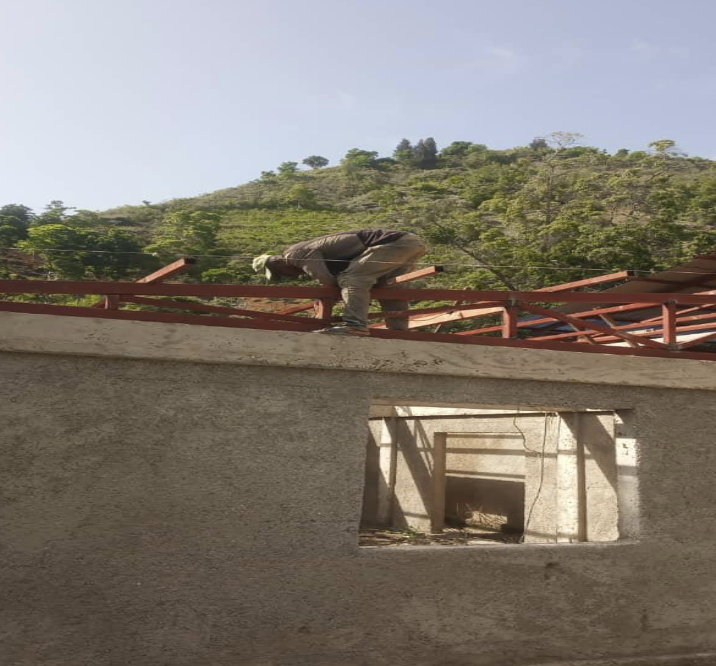

- Steel structure for roofing, block 5(Cafeteria), 100%.

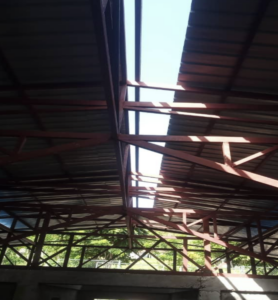

- Aluzinc sheet metal installation, main corridor, blocks 3 and 4, 95%.
