Week 61 (Aug 14-Aug 21, 2024) – Building of the Jolley School
Construction of Jolley School, School
'}}

Review of activities from the previous period :

  • Transportation of doors, 19 units 100%.
  • Transportation of windows, 100%. 21 units

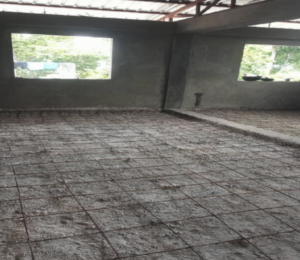

  • Steel reinforcement parquet floor, block 3 (Classrooms 1-3) ,100%.
  • Electrical flooring, block 3(Classrooms 1-3), 100%.

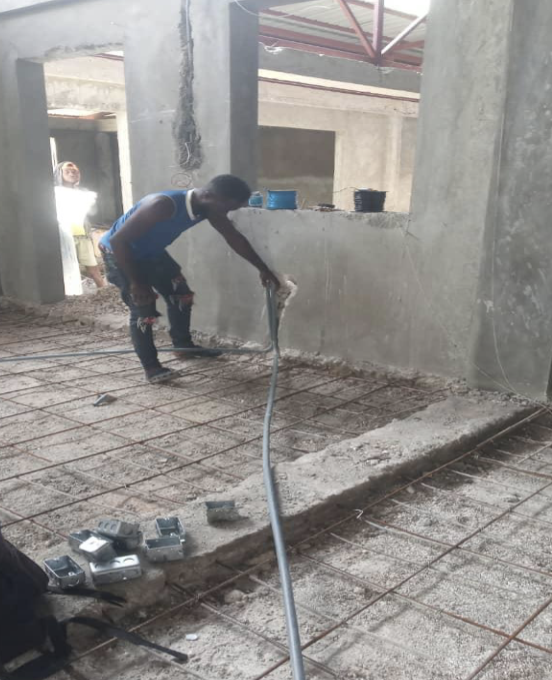

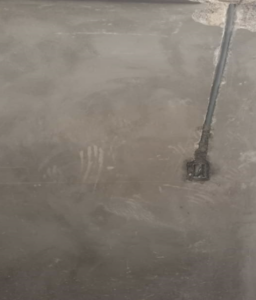

  • Concrete pouring parquet floor, block 3(Classrooms 1-3), 70%.

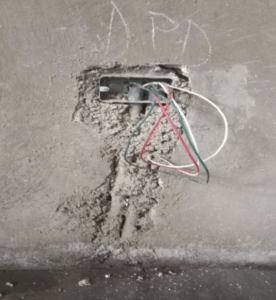

  • Plug sealing, block 1(Administration) ,100%.
  •  Plug sealing, block 2(Library / Computer) ,100%.
  • Plug sealing, block 3(Classroms 1-3) ,100%.
