Week 64 (Sept 4-Sept 11, 2024) – Building the Jolley School, Timo Haiti
September 11, 20241 min read

Update on progress:

- pouring concrete parquet flooring,block 4 ( Classrooms 4-6); This activity is completed at 75% during this week.

- Paint work block 4(Classrooms 4-6) : This activity is completed at 30 % during this week.

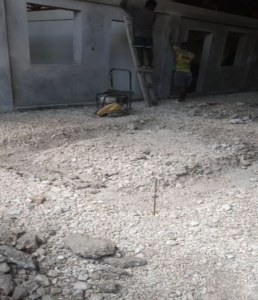

- plant boat excavation : This activity is completed during this week, 100%.

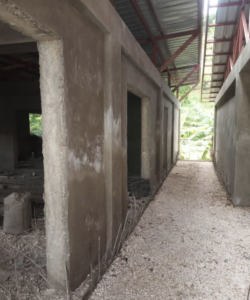

- Backfilling corridor between block 3(Classrooms 1-3) and block 4(Classrooms 4-6) This activity is completed at 95 % during this week.
- Floating, block 5(Cafeteria) : This activity is completed at 95 % during this week.

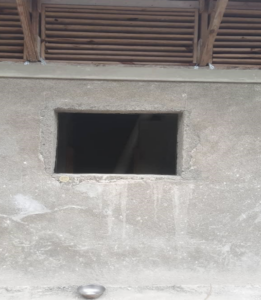

- Floating windows toilet : This activity is completed at 85% during this week.

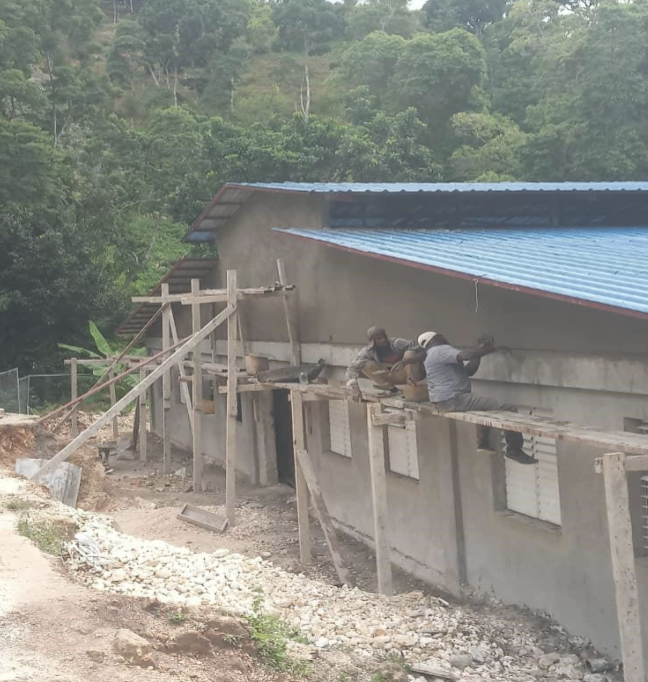

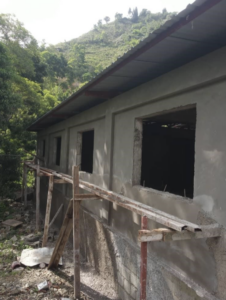

- Main facade preparation : |This activity is completed at 85% during this week.
- Roughening of electrical Outlets : This activity is completed at 80% during this week.
