Week 66 – Sept 18-25, 2024 – Building the Jolley School, Timo Haiti
September 25, 20241 min read

Below is a summary of activities completed during the previous period.

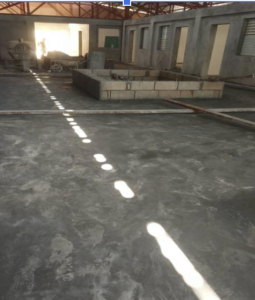

- Pouring concrete parquet flooring main corridor: This activity is completed at 85% during this week.
- Pouring concrete parquet flooring, block 5 (cafeteria) : This activity is not completed during this week.
- Electrical installation of classroom ceilings: This activity is not completed during this week.
- concrete preparation for outdoor sidewalk: This activity is completed during this week.
- Steel reinforcement corridor between block 3(Classrooms 1-3) and block 4(Classrooms 4-6) : This activity is completed at 100% during this week.

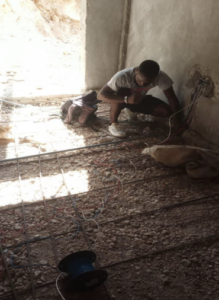

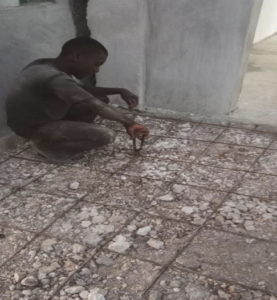

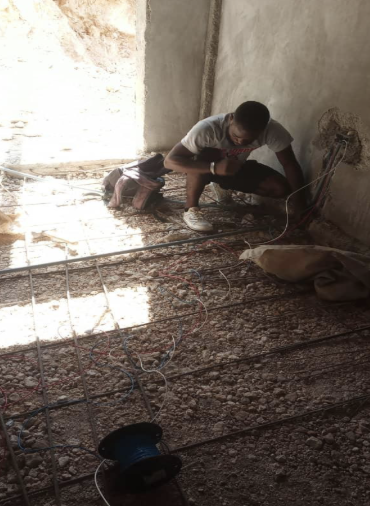

- Electrical pipe installation corridor between block 3(Classrooms 1-3) and block 4(Classrooms 4-6) : This activity is completed at 100% during this week.
- Roof repair (toilet) : This activity is completed at 98% during this week.

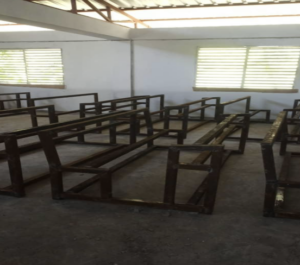

- Bench preparation : This activity is completed at 35% during this week.

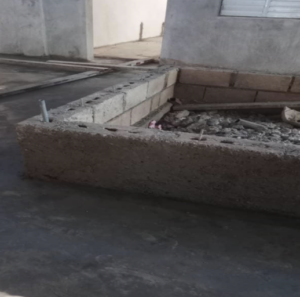

- Laying bloc plant boat: This activity is completed at 100% during this week.
- plastering plant boat :. This activity is completed at 50% during this week.
